City College New Chiller Replacement LRC HH-C-CR-001
Project Schedule
| Programming Complete | Design and DSA Approval | Construction Completion (Est.) | FFE and Move-In (Est.) |
|---|---|---|---|
| 11-01-2024 | 05-27-2025 | 10-12-2025 | N/A |
Project Progress Update

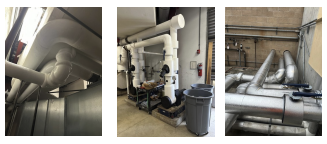

Project is currently in close out.
- 7-17-2025: Replaced breaker and balance (redundant chiller)
- 7-24-2025: Chiller put back into service
- 7-24-2025: Control Module replaced in the redundant chiller
- 8-25-2025: Final testing and balance report (TAB) received
- 8-18-2025 & 8-25-2025: Performing final commissioning to ensure system functionality with existing mechanical equipment scheduled for the week of August 18th & August 25
- 9-01-2025: Final punch walk to be scheduled for the first week of September
- 9-17-2025: Commissioning coordination meeting
- 11-26-2025: Project was accepted by Facilities. Notice of Completion has been issued.
Project Features

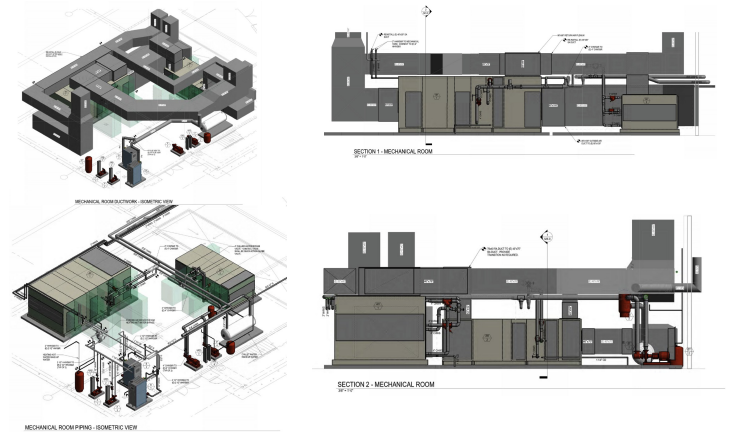

This project involves the procurement, replacement, and installation of the Learning Resource Center Cooled Scroll Chiller system at City College. The scope includes replacing two existing chillers, two boilers, two air handling units, two chiller pumps, two boiler pumps, as well as the existing chiller/boiler expansion tanks and air separators at the LRC building.

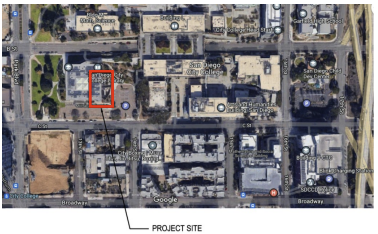

Project Site Plan

Look Ahead
The next stage of the project will focus on finalizing and completing the control module replacement in the redundant chiller, followed by the final project completion activities and full site demobilization. Final punch list walk scheduled for first week of September. Commissioning meeting scheduled for 9-17-2025.
Project News & Information
Additional resources, articles, and links related to this project will appear here when available. For comprehensive information about Measure HH and all ongoing projects, please explore the Measure HH website.
Project Teams
| General Contractor | ACCO Engineering |
| Architect | N/A |
| Structural Engineer | AARK Engineering |
| Civil Engineer | N/A |
| Mech./ Elect. Engineer | Bender-Dean |
| Executive Const. Manager | Steve Evanco |
Project Overview
| Current Status / Phase | Construction Close Out |
| Construction Type | Equipment Replacement |
| Gross Square Footage | N/A |
| Division of State Architect | N/A |
| Construction Method | Traditional Design-Bid-Build |
| Contract Start Date | June 2, 2025 |
| Contract Expiration Date | August 8, 2025 |
Project Financials
| Funded By | HH Bond |
| Programmed Budget | $763,146 |
| Current Budget | $763,146 |
| Expenditures to Date | $0.00 |
Site Detail
| Campus | City College |
| Coordinates | 32° 43′ 05.39″ N, 117° 09′ 09.15″ W |
Last updated: March 31, 2026
