San Diego Miramar College Building A200
Project Schedule
| Programming Complete | Design and DSA Approval | Construction Completion (Est.) | FFE and Move-In (Est.) |
|---|---|---|---|
| 09-01-2025 | N/A | TBD | N/A |

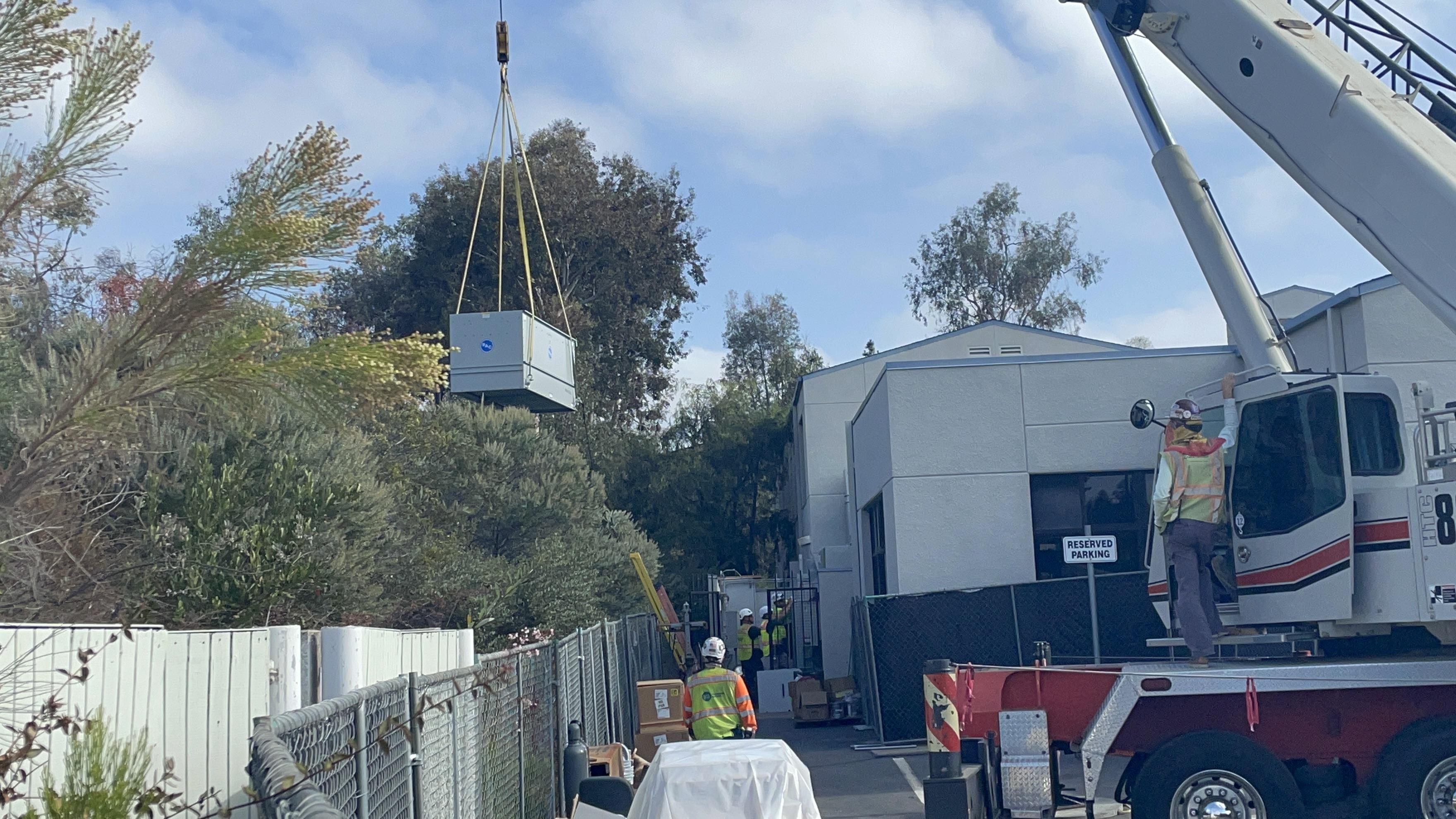

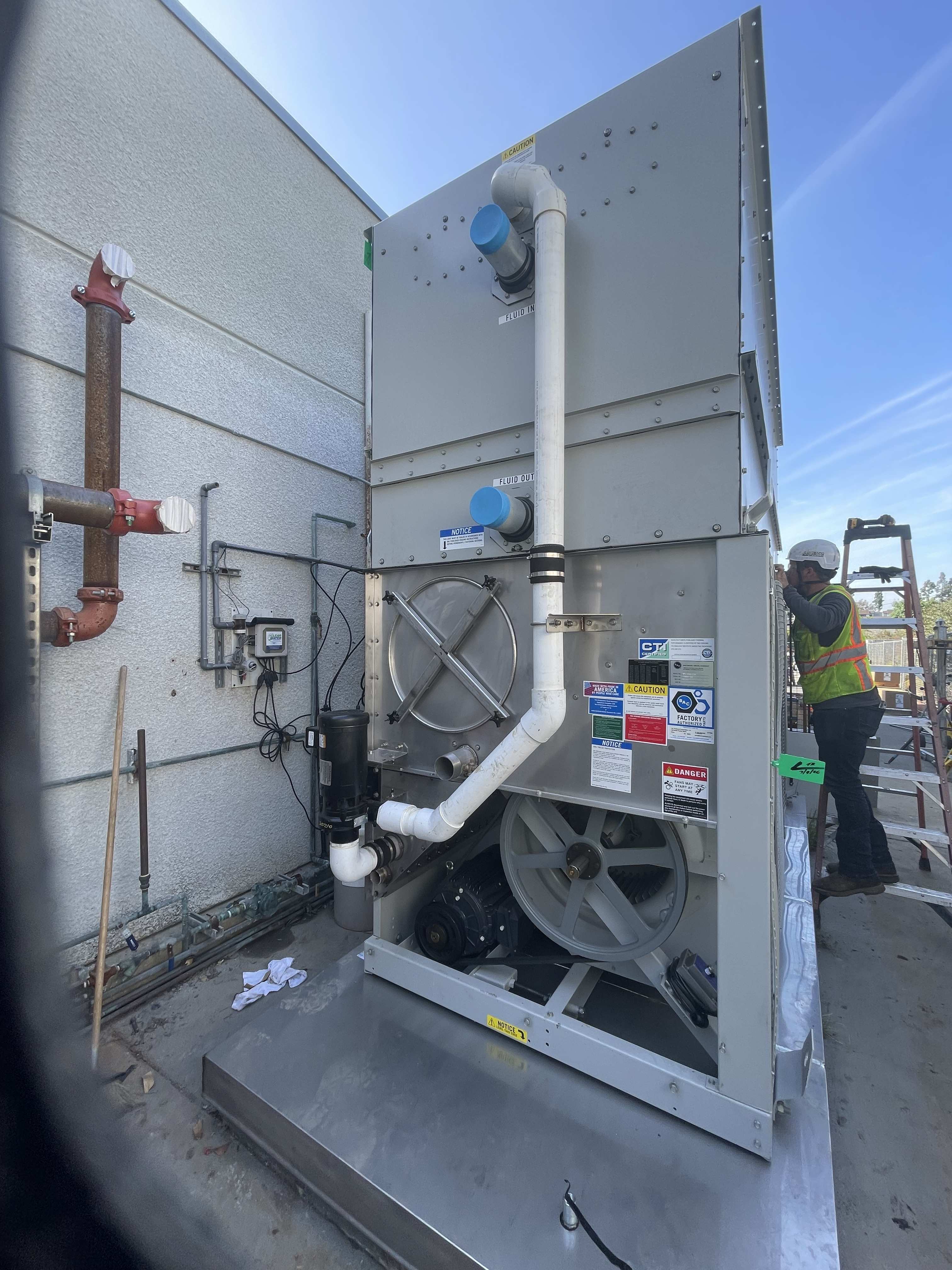

Project Progress Update

Upcoming Milestones:
- Contract and Notice to Proceed (NTP) issued to Shadpour Consulting Engineers: November 18, 2025
- 95% Schematic Design Package for the Police Academy Bldg. A200 MAT Room HVAC Mechanical Design: December 24, 2025
- Bids due for the project February 17, 2026
- Contract award anticipated March 2026
- Bid walks scheduled January 30 and February 6, 2026
Project Description

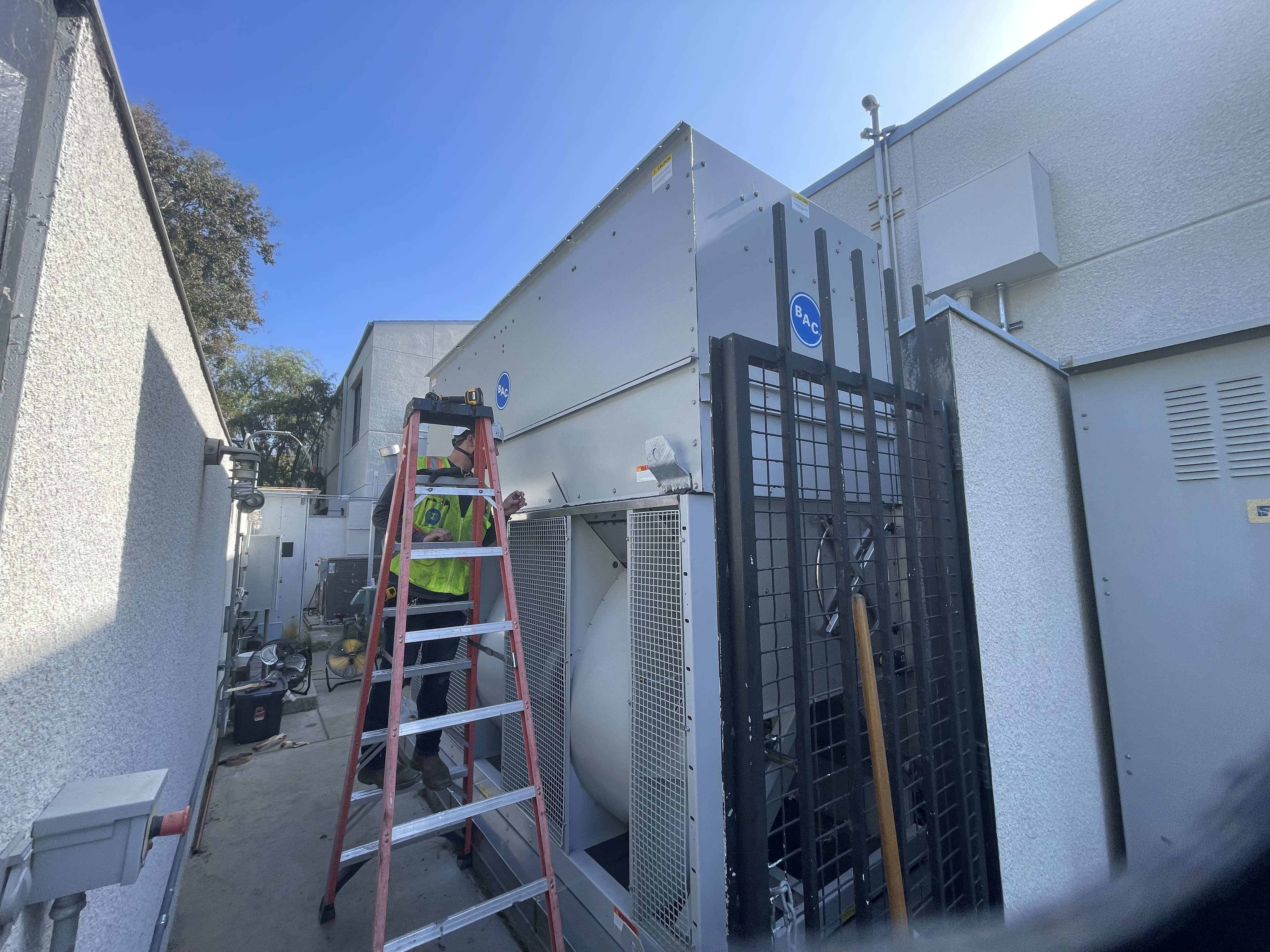

- Replace the existing packaged air-conditioning unit.
- Existing unit is located on an existing concrete pad.
- Unit serves the mat room training area of the police academy.
- New unit will be appropriately sized to meet the room’s load requirements.
- Design will be based on a readily available replacement packaged AC unit.

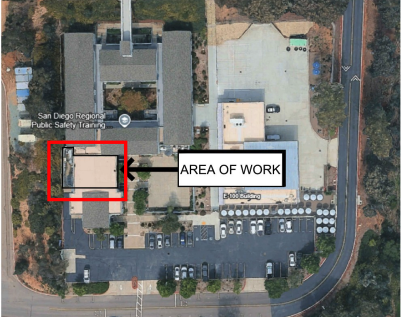

Project Map

10440 Black Mountain Rd, San Diego, CA 92126
Project News & Information
Additional resources, articles, and links related to this project will appear here when available. For comprehensive information about Measure HH and all ongoing projects, please explore the Measure HH website.
Project Teams
| General Contractor | TBD |
| Architect | Lance Lareau |
| Structural Engineer | Miyamoto International |
| Civil Engineer | N/A |
| Mech./ Elect. Engineer | Shadpour Consulting |
| Executive Const. Manager | Steve Evanco |
